September 9, 2026
Natelli Files 900 MW Campus Plan
Natelli Holdings LLC filed a phased development plan for a 900 MW data center campus on 528 acres between I-85 and US-158, east of Poplar Creek Road. The same day, they submitted a redlined version of the county's draft Unified Development Ordinance, weakening protections across the board. The moratorium has not been adopted.
Every claim on this page is sourced to filed documents and public records.
The Filing
Key Facts
Source: Vance County Technology Campus Final Site Plan, NC Rodgers Consulting for Natelli Holdings LLC, filed September 9, 2026.
900 MW
Total campus capacity
528.92 acres
Nine parcels between I-85 and US-158
Up to 12
Buildings plus security building and auxiliary facilities
4,000,000 sq ft
Total data center space
4 phases
Multi-phase development plan
Light Industrial
Zoned by right, no rezoning required
Background
Who Is Natelli
Natelli Holdings LLC
Also referenced in filings as Natelli Investments LLC. c/o Natelli Holdings, 1903 N. Harrison Avenue, Suite 100, Cary, NC 27513. Contact: Thomas Natelli Jr.
Prior Activity
Natelli's Apex, NC proposal -250 MW, 189 acres near the Shearon Harris Nuclear Plant -was withdrawn in March 2026 after 4,700 petition signatures and opposition from a U.S. Representative. Apex then voted unanimously to draft a data center moratorium. The same developer is now in Vance County with a project nearly 4x the size.
Sources: WRAL, Triangle Business Journal, Town of Apex public records.
The Legal Strategy
The Vesting Play
Once site plan approval is granted for the initial phase, the entire multi-phase development is vested under the rules in place at that time, for seven years. Separately, NCGS 160D-107 states that a development moratorium does not apply to development set forth in a multi-phase development plan.
In Their Own Words
Natelli's letter states they have been “closely following the discussions around the possible imposition of a moratorium and adoption of new regulations” and that “the uncertainty this causes is very problematic,” so they “reluctantly made the decision today to file a plan for development of the site.”
Translation
If the county approves Phase 1, the entire 900 MW, 4-phase campus locks in under current rules for 7 years. Even if a moratorium is adopted tomorrow, NCGS 160D-107 exempts vested multi-phase plans.
The moratorium has not been adopted as of September 12, 2026.
Sources: NCGS 160D-108(j)(4), NCGS 160D-107, Natelli letter dated September 9, 2026.
Most Important Section
The UDO Redline
Natelli submitted a marked-up copy of the county's draft UDO Section 5.13.4 (Data Centers). Below is every change they requested.
Footnote 300
The draft UDO states: NFOCUS had recommended more restrictive standards in 2022 with the original data center amendment, but the recommendation was “deemed unnecessary.” Vance County was told what standards to adopt four years ago and said no. They are now writing them under deadline while the applicant marks up the draft.
Source: Vance County Draft UDO, July 2026, Sec. 5.13.4, footnotes 300–308.
| What the County Proposed | What Natelli Wants | Why It Matters |
|---|---|---|
| School/hospital/daycare separation: 1,000 feet | 500 feet | Cuts the buffer zone in half for the most sensitive community facilities. |
| Residential setback: 500 feet from residential property | Waived when the adjoining parcel is under common ownership with the data center | If Natelli owns the adjacent residential-zoned lot, they can build right up to it. NFOCUS originally recommended 300 feet (footnote 303). |
| Maximum height: 60 feet | 75 feet, measured from finished ground level to roof membrane | 15 feet taller, with a measurement method that could add more. |
| Privacy fence: 8-foot fence required | “In areas where necessary” | Discretionary language that allows skipping the fence entirely. |
| Utility confirmation: County “shall require” utility provider documentation | County “shall request” | Changes a mandate to a request. The utility provider is no longer obligated to confirm capacity. |
| Cooling systems: Closed-loop systems required | “Closed loop or hybrid systems which utilize closed loop, air or evaporative cooling” | Opens the door to evaporative cooling, which consumes millions of gallons per day. This is the single most consequential change. |
| Generator use: Only during power disruptions | Also “when specifically required by Duke Energy, the State of North Carolina or the NC Utilities Commission” plus routine testing and maintenance | Expands when diesel generators can run, increasing noise and emissions. |
| Abandonment trigger: 12 months of ceased operations = abandoned | 18 months, plus “clear and convincing evidence” standard required, plus extensive list of activities that do NOT constitute abandonment | Makes it nearly impossible for the county to declare a facility abandoned. Maintenance of permits, insurance, security, or even “marketing” counts as active use. |
| Abandoned infrastructure: Private substations removed | “Private substations, sewer pump stations, water treatment facilities and infrastructure which could benefit future uses on the site shall be retained for future use at the option of the property owner” | The owner keeps private utility infrastructure indefinitely. |
| Consultant review: County reviews application | “At the request of the applicant, the Planning Department shall arrange an informal consultation with the applicant to review the consultant's report prior to any formal action” | The applicant gets to see and respond to the county's own expert analysis before any public hearing. |
Source: Vance County Draft UDO, July 2026, Sec. 5.13.4, footnotes 300–308.
Water Impact
What 900 MW Actually Means for Water
Our original analysis estimated a single data center at 300,000 to 1 million gallons per day. That figure is accurate for a single building in the 30–100 MW range. Natelli's filing changes the scale entirely: a 900 MW campus with up to 12 buildings, and a redline that specifically allows evaporative cooling.
| Scenario | Daily Water Use | Annual |
|---|---|---|
| Full evaporative (worst case) | ~10.3 million gal/day | ~3.76 billion gal/yr |
| Hybrid cooling (Natelli's redline allows this) | 3.6–6.2 million gal/day | 1.3–2.3 billion gal/yr |
| Pure closed-loop (best-in-class) | ~1.35 million gal/day | ~493 million gal/yr |
| Zero-water air-cooled (Microsoft new gen) | Near zero | Near zero |
Real-World Comparisons
Vantage 1,300 MW campus -WI
22,000 gal/day
Closed-loop. vs 5 million gal/day if evaporative - a 227x difference.
Source: Vantage Data Centers blog
Context
At the hybrid-cooling midpoint (5 million gallons per day), Natelli's campus would consume the equivalent daily water demand of 50,000 to 60,000 people, more than the entire population of Vance County (approximately 43,000). The KLRWS currently draws 6.9 MGD to serve all of its customers across four counties. No public analysis has been provided by Natelli on the water requirements of this campus.
Natelli's redline changes the county's proposed “closed systems” requirement to “closed loop or hybrid systems which utilize closed loop, air or evaporative cooling.” The word “or” is doing enormous work. It is the difference between 22,000 gallons per day and 5 million.
Drought - September 11, 2026
The U.S. Army Corps of Engineers reports Kerr Reservoir is at 289.9 feet - 9.6 feet below the target elevation of 299.5 feet. Ten of the past 12 months had below-normal inflows, ranking in the top 10 driest inflows on record. Six of those months were in the top 3 driest ever recorded. A Drought Management Committee was assembled on August 6. Boat ramps are becoming inaccessible. This is the reservoir Franklin County wants 15.7 MGD from, and the same water system Natelli's campus would draw from.
Source: USACE Wilmington District News Release, September 11, 2026. Boydton, VA.
Sources: AKCP Data Center Water Footprint 2026, Introl WUE Guide,MOST Policy Initiative, WUNC April 2026, WRAL, Vantage Data Centers, GIJN.
Timeline
What Happens Next
The moratorium has NOT been adopted as of September 12, 2026.
The Proposed 60-Day Moratorium
A moratorium notice was published September 5, 2026. The proposed ordinance is a temporary 60-day measure that would terminate the earlier of November 13, 2026 or upon adoption of UDO data center amendments. It has not been adopted. A public hearing is scheduled for September 14, 2026. The draft ordinance acknowledges that data centers were added as permitted by right in L-I and O-I zones on February 5, 2024 “with no additional requirements for such development.”
The ordinance also states there are “no known large scale active and one pending data centers in Vance County” -confirming Natelli is the pending application.
Critical Exemption -Section 2 of the Moratorium Ordinance
The moratorium “shall not apply to:”
- (i)any complete land development applications currently in review
- (ii)the development of an ancillary or accessory use of a data center
- (iii)nothing herein shall impair vested rights established pursuant to North Carolina law
This means Natelli's September 9 filing -if accepted as a complete application -may be exempt from the moratorium by the moratorium's own text. Natelli filed four days after the moratorium notice was published.
Why They Filed When They Did
“We have been closely following the discussions around the possible imposition of a moratorium... The uncertainty this causes is very problematic for us at this stage of our efforts. We therefore reluctantly made the decision today to file a plan for development of the site.”
Natelli letter, September 9, 2026. The moratorium notice was published September 5. Natelli filed four days later.
September 14, 2026 -Board of Commissioners Meeting
Three public hearings relevant to data center development are on the agenda:
- Item 5 - 6:20 PMZMA26-002- Rezoning request (CPNONE LLC), GC1 to HC, US 1-158 Hwy & Warrenton Rd. Not a data center application, but part of the same meeting.
- Item 6 - 6:30 PMOA26-001 - UDO Section 4 text amendment adding data center development standards
- Item 7 - 6:40 PMProposed 60-day moratorium on new data center development (Jonathan Care, County Attorney)
The Critical Fork
- ◆If Natelli's September 9 application is deemed complete, it may already be exempt from the moratorium under Section 2(i).
- ◆If Phase 1 is approved, the entire campus vests for 7 years under NCGS 160D-108(j)(4) -and NCGS 160D-107 separately exempts vested multi-phase plans from moratoriums.
Sources: Vance County Board of Commissioners Masterfile, September 14, 2026 meeting. NCGS 160D-107, 160D-108.
Chronology
Key Dates
| Date | Event |
|---|---|
| February 5, 2024 | Board permits data centers by right in L-I and O-I zones - no additional requirements |
| August 25, 2026 | Joint BoCC/Planning Board work session -consensus to draft UDO text amendment |
| September 3, 2026 | UDO amendment public notice published |
| September 5, 2026 | Moratorium public notice published |
| September 9, 2026 | Natelli files 900 MW multi-phase development plan and redlined UDO -four days after moratorium notice |
| September 10, 2026 | Planning Board reviews text amendment |
| September 14, 2026 6:20 PM | Public Hearing -ZMA26-002 rezoning (CPNONE LLC) |
| September 14, 2026 6:30 PM | Public Hearing -OA26-001 UDO data center text amendment |
| September 14, 2026 6:40 PM | Public Hearing -60-day moratorium ordinance |
| September 15, 2026 | Staff deadline to present text amendments to Planning Board |
| October 5, 2026 | Target date for public hearing on new zoning ordinance |
| November 13, 2026 | Moratorium expiration (if not extended or superseded by new ordinance) |
Source: Vance County Board of Commissioners Masterfile, September 14, 2026 meeting.
Primary Sources
Documents
Natelli Filing Documents
Images from Natelli's September 9, 2026 filing - the letter and their redlined UDO submission. Click any image to open full size.

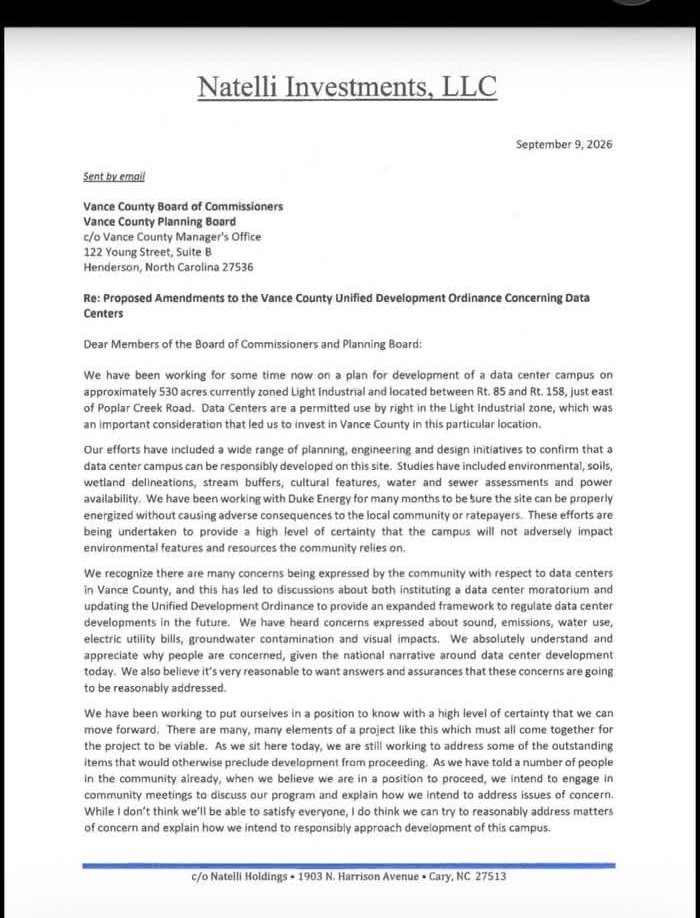

Natelli Letter - Page 1
September 9, 2026

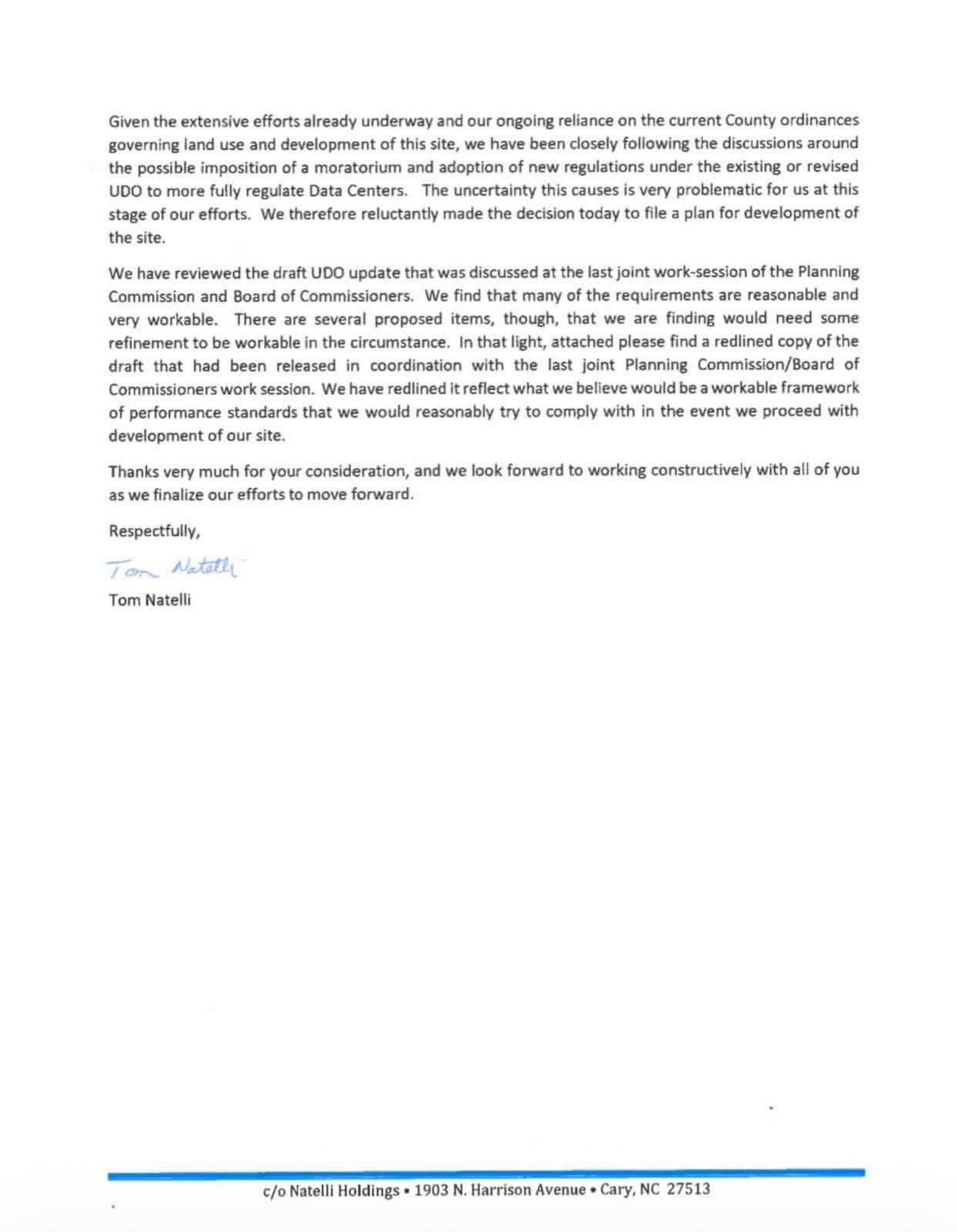

Natelli Letter - Page 2
Filed to vest rights

UDO Redline - Sec. 5.13.4
Data Centers section begins

UDO Redline - Setbacks
Common ownership waiver, school separation

UDO Redline - Height & Noise
60 to 75 ft, fence changes, noise threshold

UDO Redline - Utility & Cooling
Require to request, evaporative cooling added

UDO Redline - Cooling & Abandonment
Generator expansion, 12 to 18 month abandonment

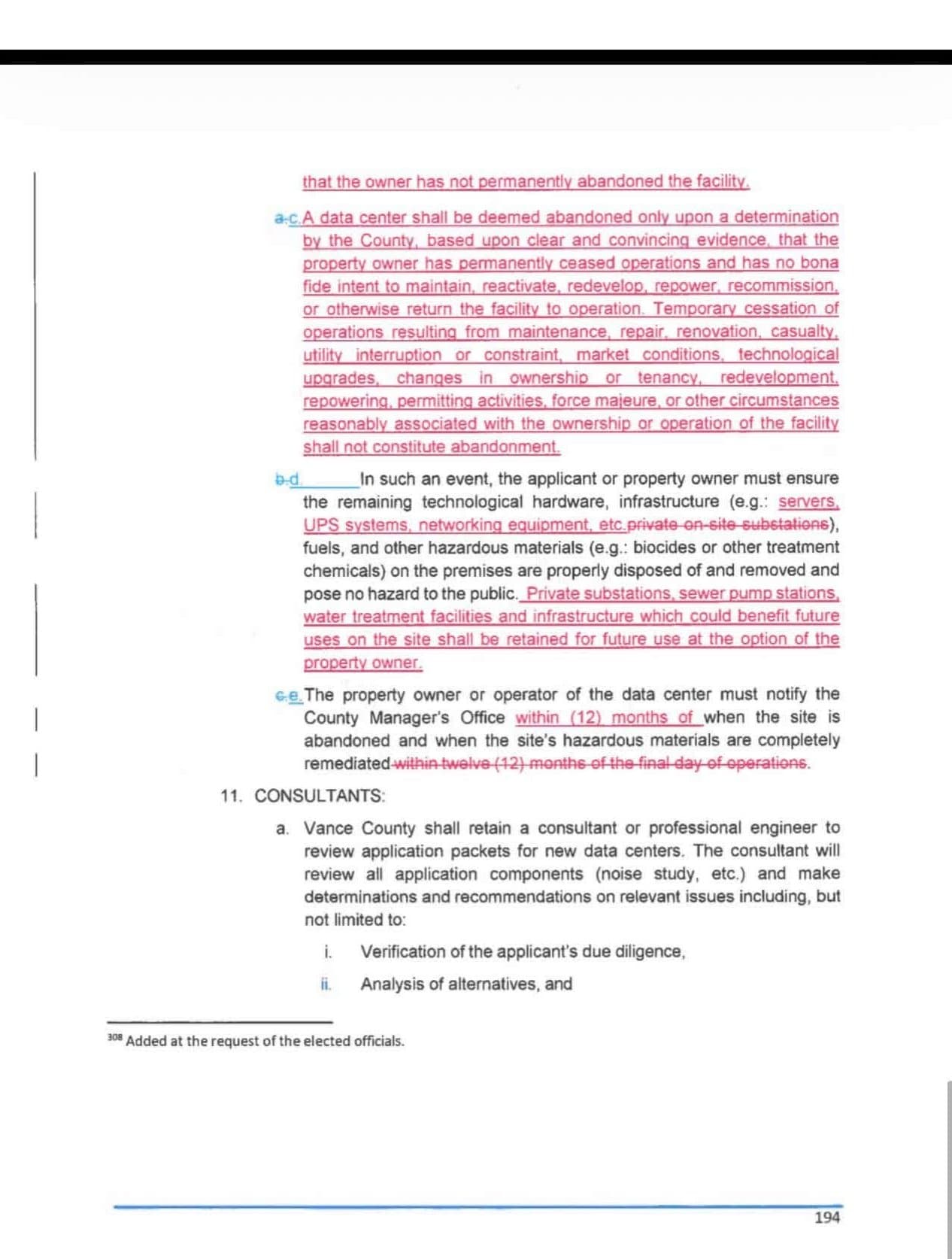

UDO Redline - Abandonment & Consultants
Clear and convincing evidence standard

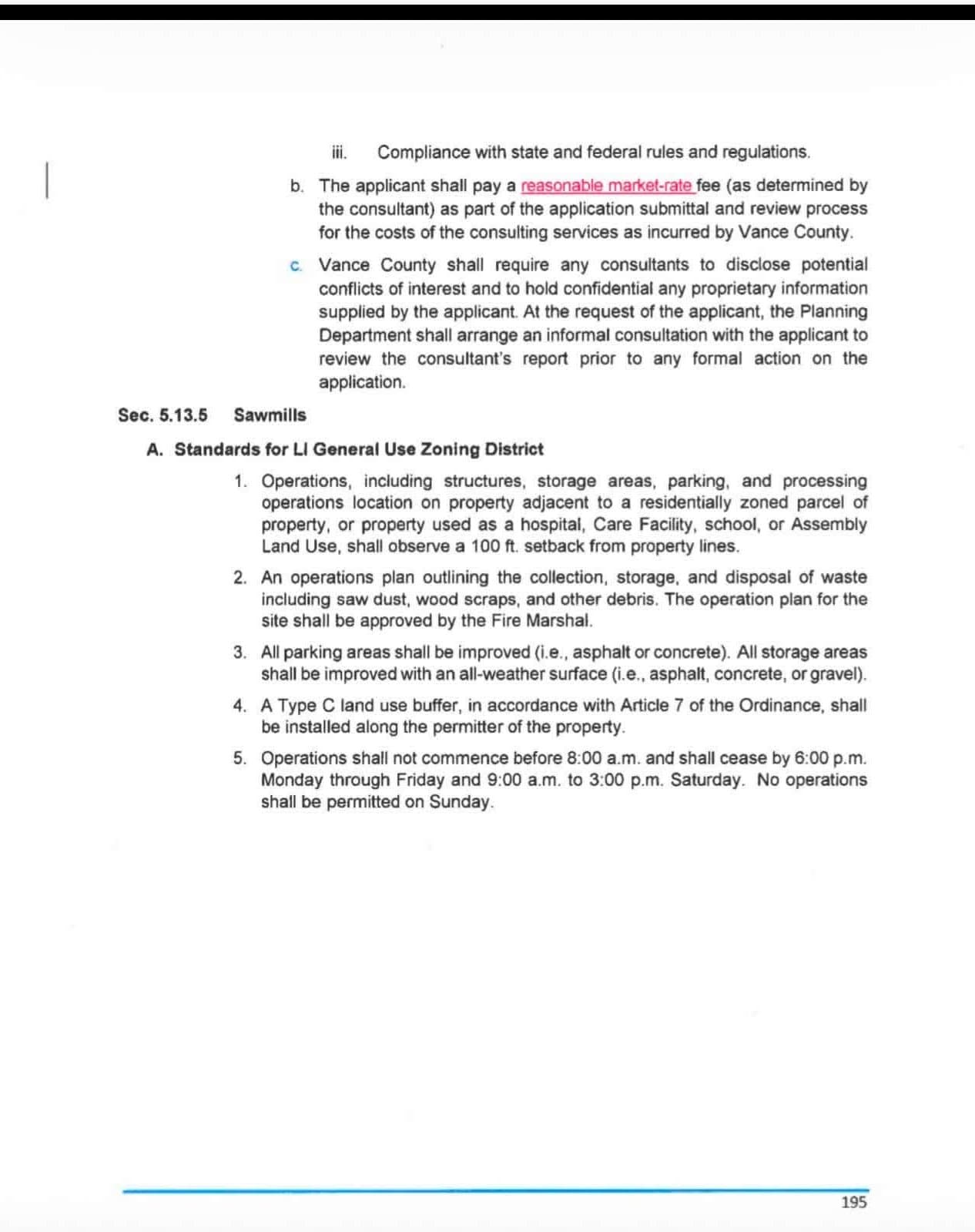

UDO Redline - Consultants
Pre-review consultation, market-rate fees

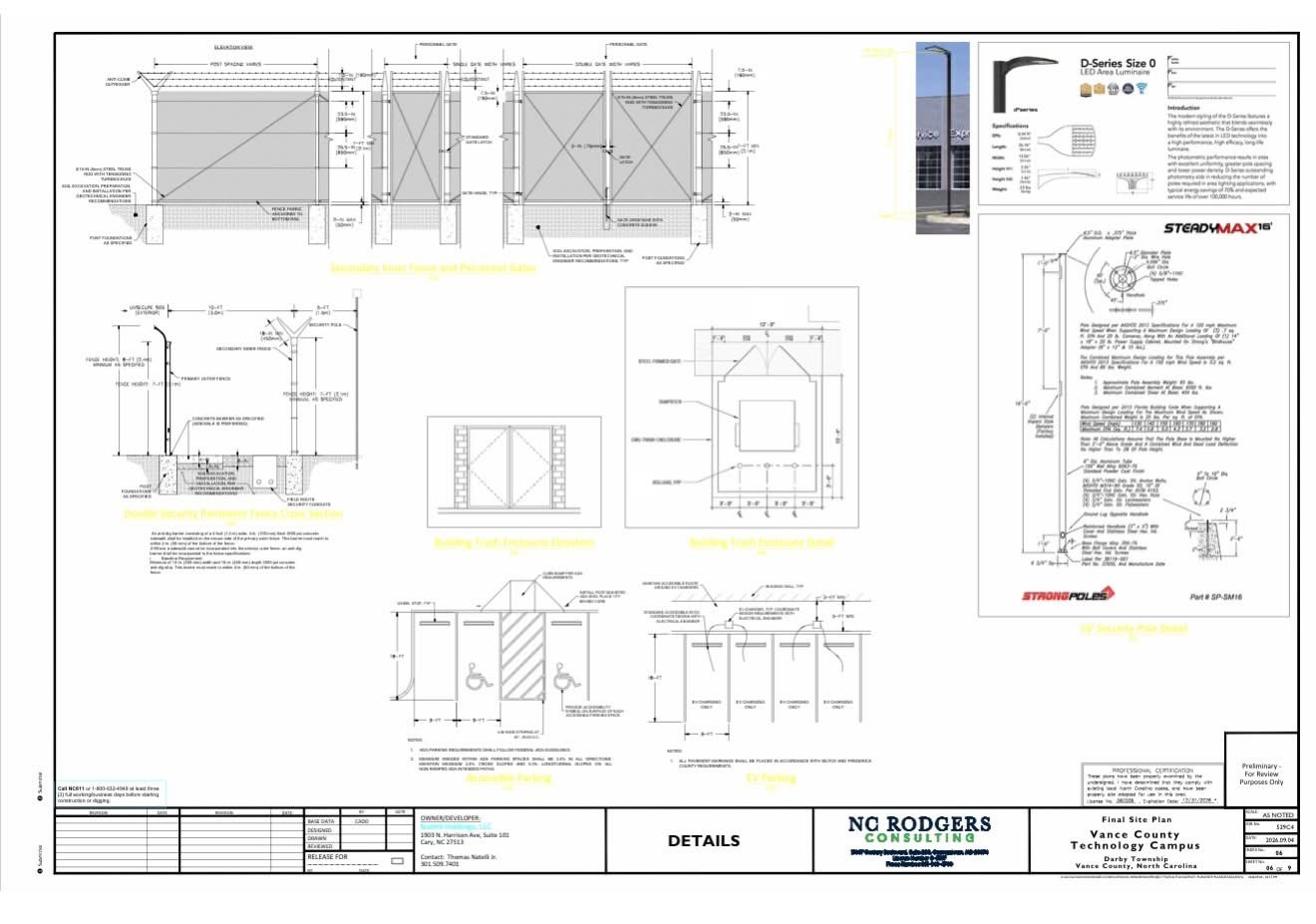

Site Plan - Details
Fencing, security, lighting, parking, building entrance

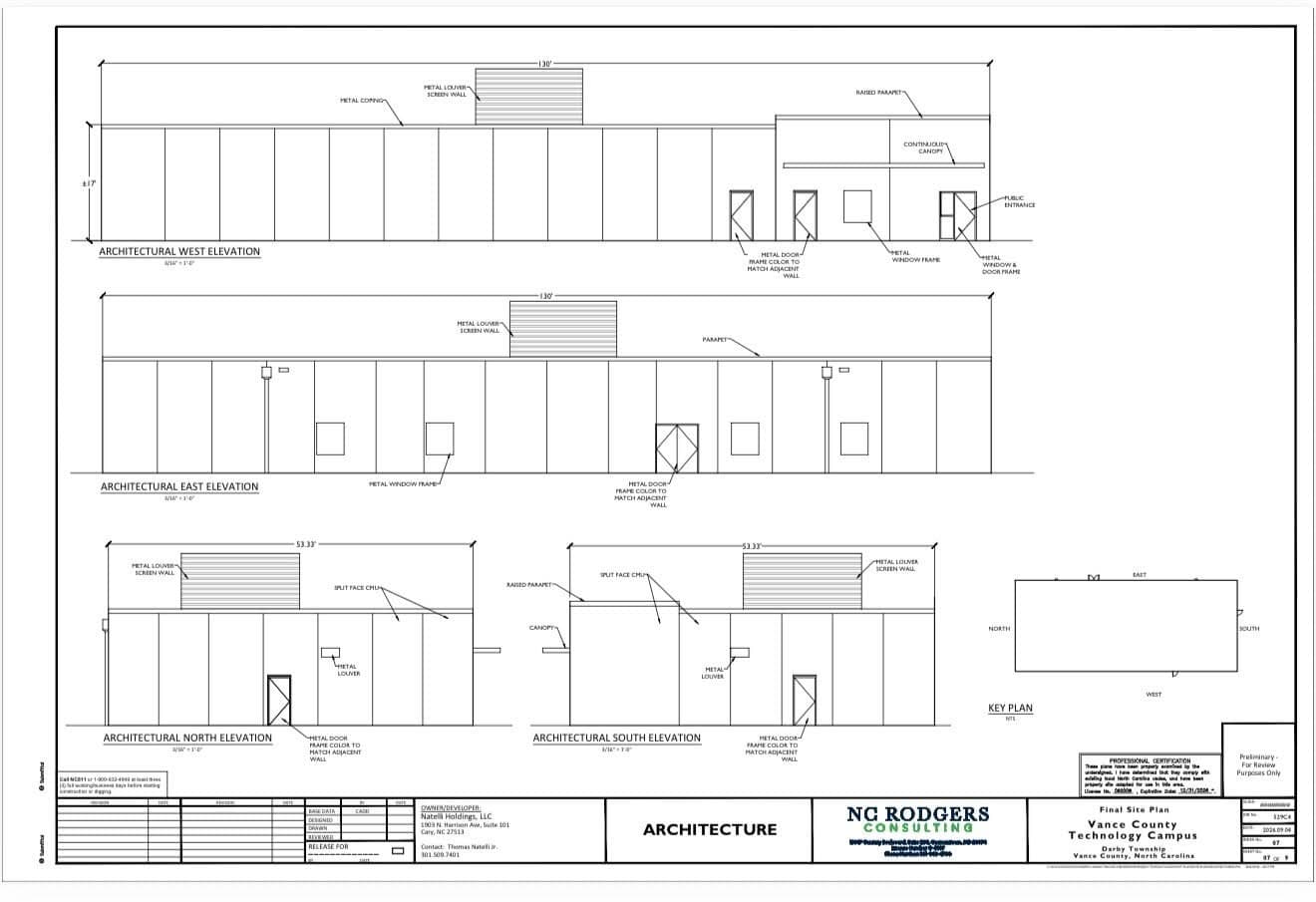

Site Plan - Architecture
Building elevations (all 4 sides), 130 ft wide, 41.7 ft tall

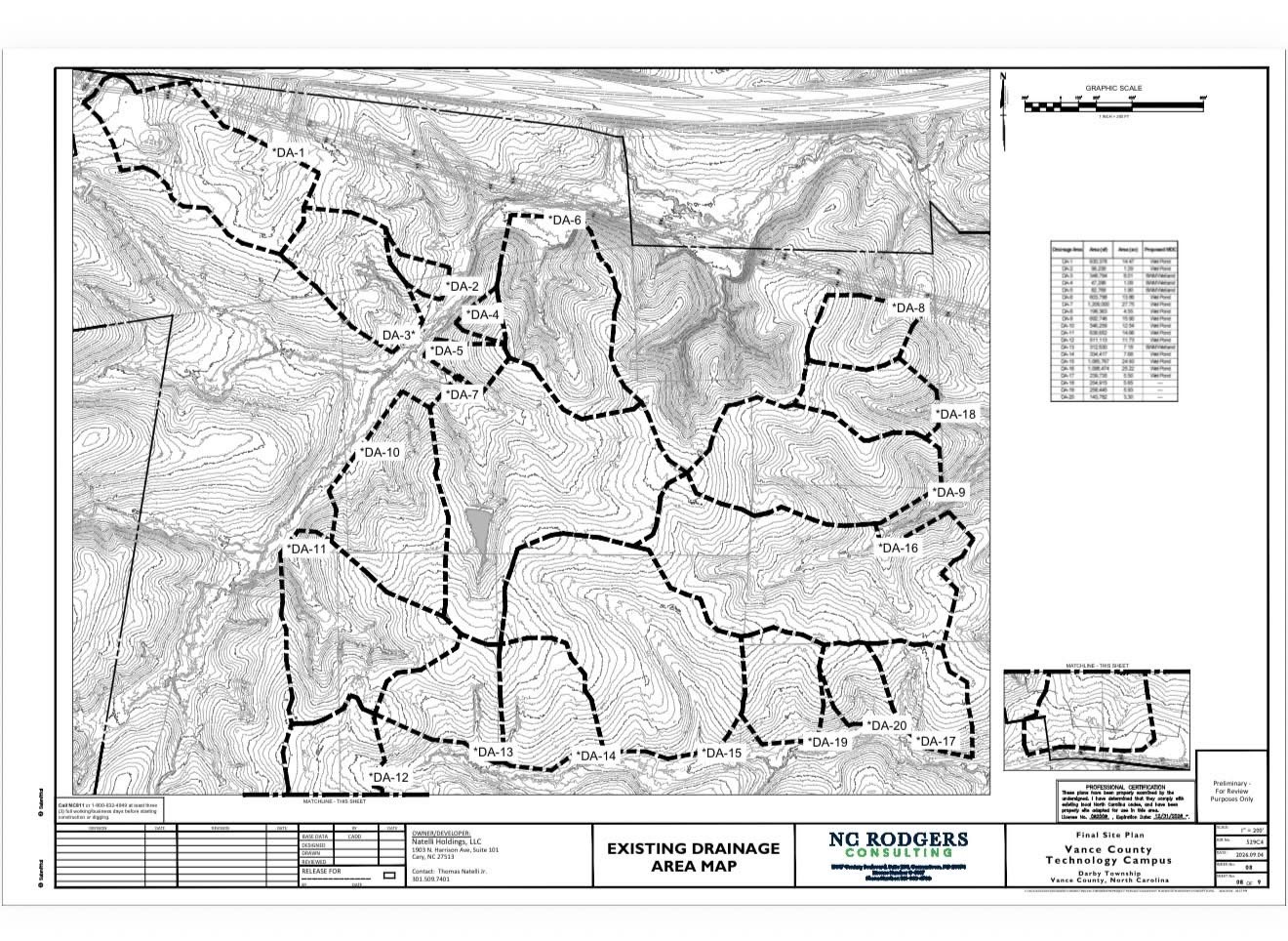

Site Plan - Existing Drainage
20 drainage areas mapped across the site

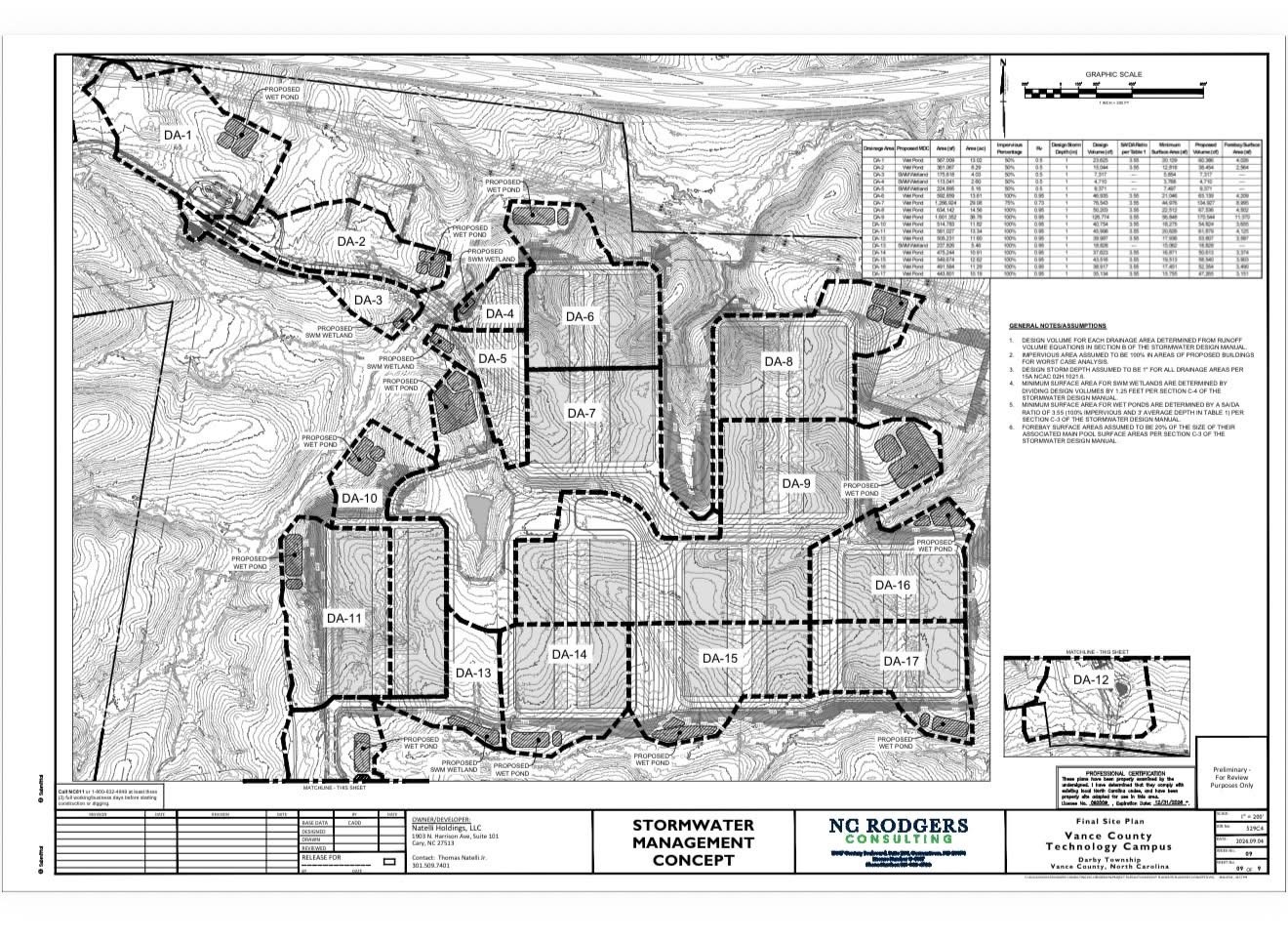

Site Plan - Stormwater Management
Proposed wet ponds and SWM wetlands

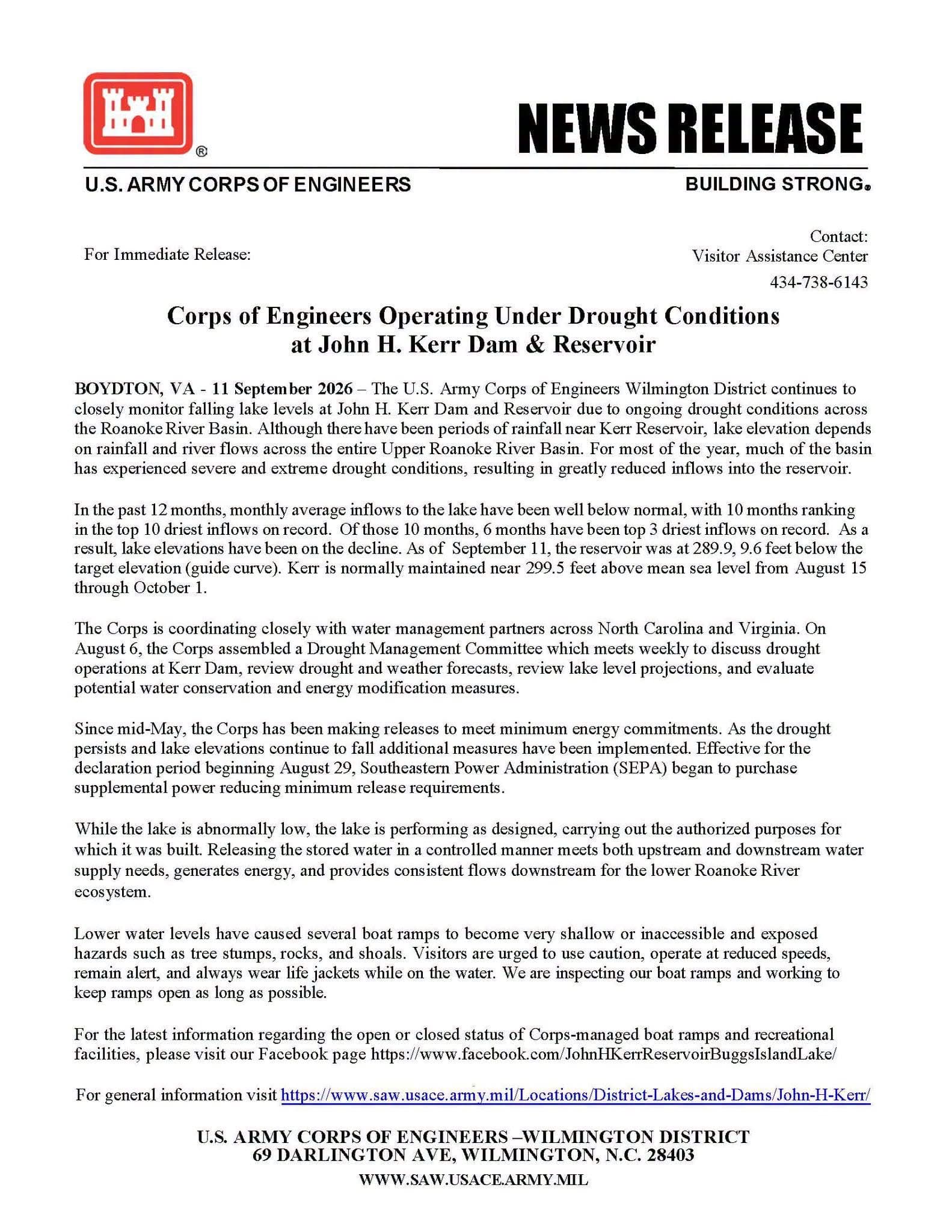

USACE News Release - Sept 11, 2026
Kerr Lake 9.6 ft below target, driest inflows on record
Additional Resources
September 14 Board Meeting Masterfile (full PDF, 69 MB) - vancecounty.org
Vance County Draft UDO, July 2026 - vancecounty.org
Vance County Public Records Repository - vancecounty.org
WIZS: Data Center Developer Files Plan Amid Talk of Moratorium - wizs.com
Vance County Data Center Fact Sheet - vancecounty.org
Related Research
What We Already Know
Noise & Infrasound
What does a data center actually sound like?
20 visual cards on audible noise, infrasound, distance decay, and what good regulation looks like. Sourced from peer-reviewed research.
SB 730 Analysis
The Ratepayer Protection Act
What SB 730 does, what it misses, and why it matters for Vance County. 100 MW threshold, cooling mandates, tax exemption gaps. Stalled in Senate since June.
Economic Development
The Conversation Has Been Brought to the Table
Independent analysis of the State of Economic Development presentation. Jobs, tax revenue, incentives, and what other communities demanded. 40+ sources.
Water & SB 214
The Kerr Lake Water Question
SB 214 Section 5, the Franklin County letter, KLRWS ownership, Kerr Lake allocations, and the Army Corps reallocation study. Full timeline and analysis.
